Higashiogu Water Reclamation Center

Constructing robust underground structures that ensure functionality and stability is essential when building critical infrastructure such as pumping stations, shafts, and road tunnels. The pneumatic caisson method is particularly valuable under challenging conditions, including soft ground and underwater environments, because it provides a safe and reliable means of construction. Shimizu has been involved in numerous large-scale projects using this specialized method over many years, contributing to the development of social infrastructure. This page introduces some of our pneumatic caisson projects and the innovative technologies we have developed and deployed.

What Is the Pneumatic Caisson Method?

A pneumatic caisson is literally an “air box.” An airtight working chamber is constructed at the bottom of a reinforced-concrete structure built above ground. Compressed air is then supplied to the chamber to prevent groundwater from entering while excavation and soil removal are carried out, allowing the structure to be gradually sunk into the ground.
The method applies the same principle seen when an upside-down glass is pushed into water: the air trapped inside prevents water from entering. As a result, excavation can be performed inside the working chamber at the bottom of the caisson under conditions similar to those above ground.

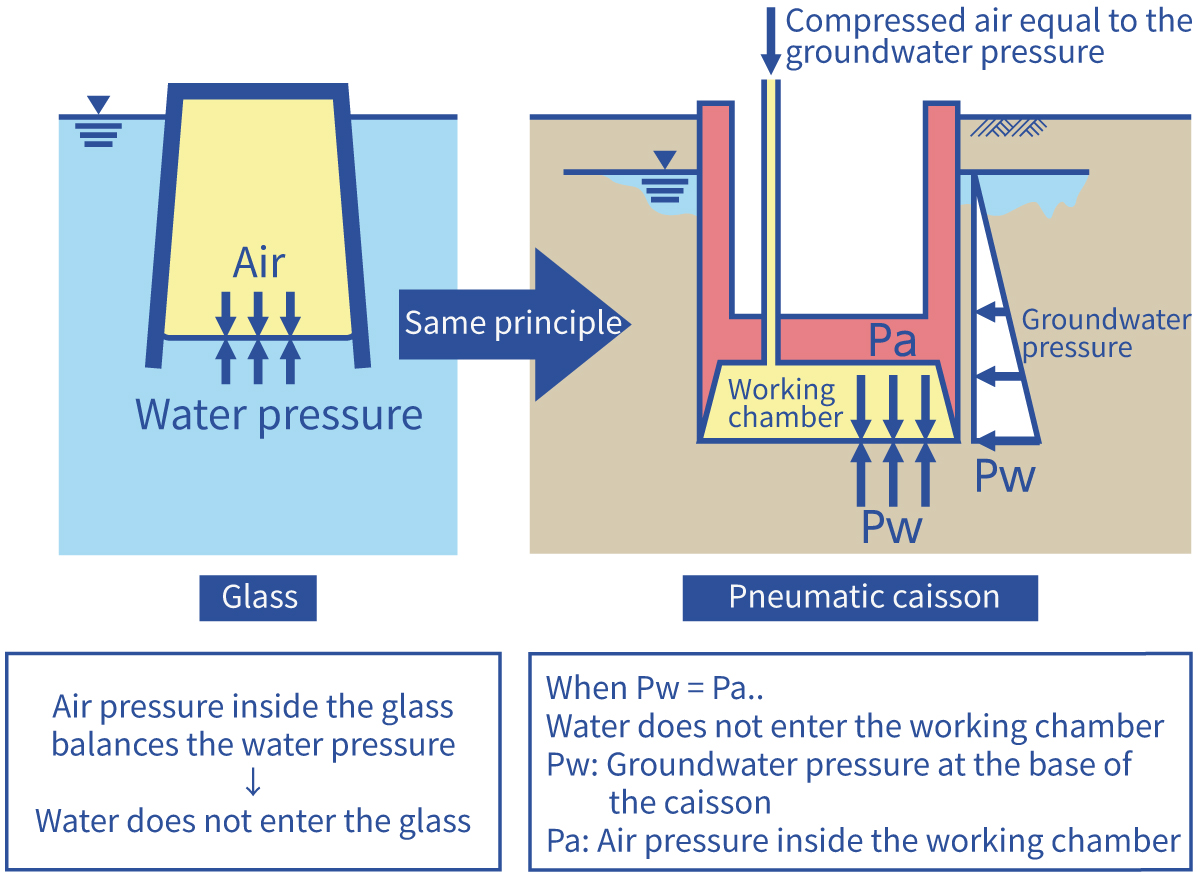

Conceptual diagram of a pneumatic caisson

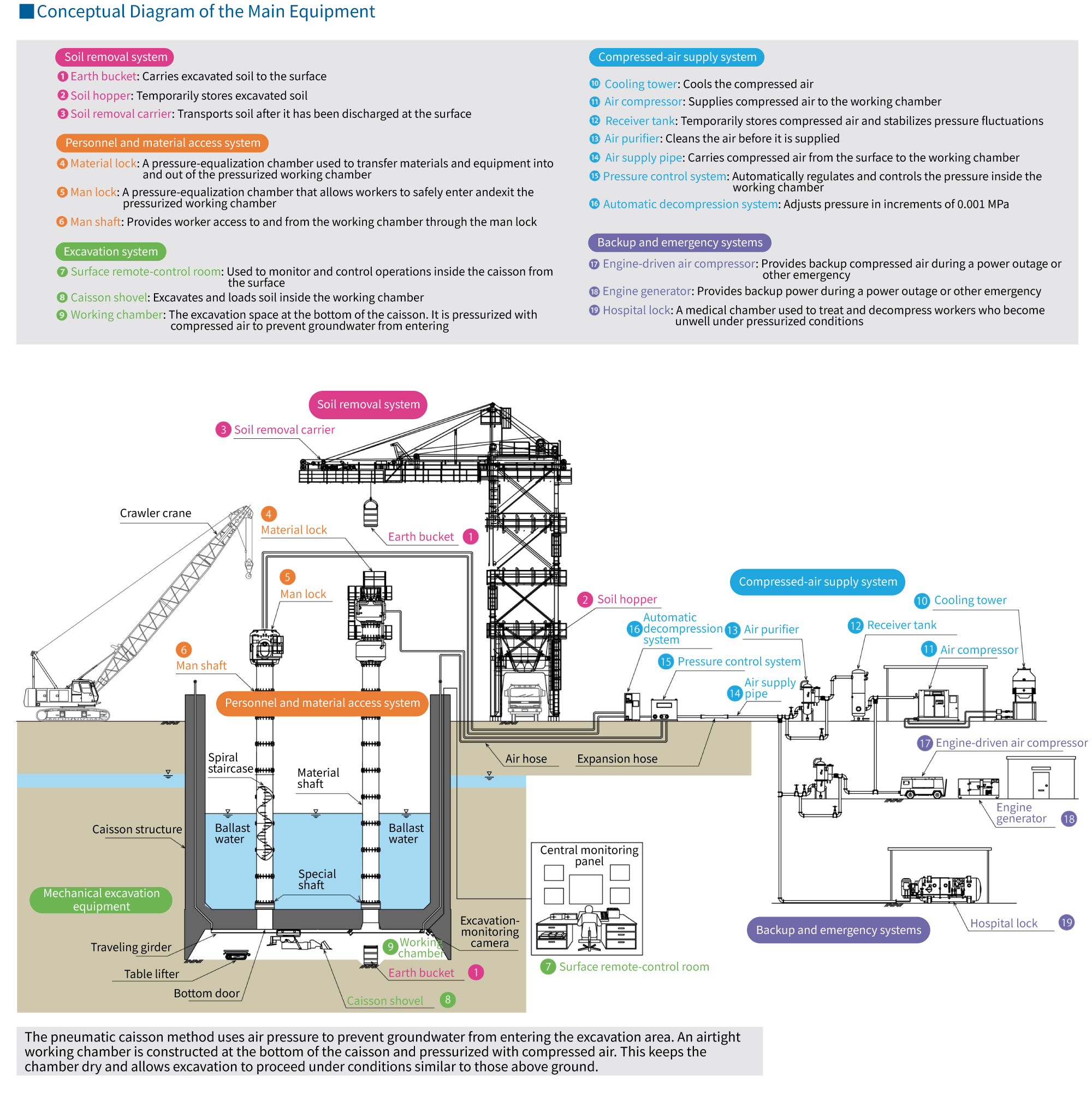

Conceptual diagram of a pneumatic caisson
Conceptual diagram of a pneumatic caisson

Continuous Construction Using Multiple Pneumatic Caissons
New Saitama East-West Connector Road between Kita-Yono and Omiya on the Saikyo Line

This project formed part of the Omiya Route of the Metropolitan Expressway, which directly connects central Tokyo with Saitama Shintoshin, an important center supporting the functions of Japan’s capital region. The work involved constructing a tunnel beneath the elevated JR East Shinkansen and Saikyo Line tracks. A 221.5-meter road tunnel was constructed as a single integrated structure by sinking six pneumatic caissons in succession.

Road tunnel constructed using continuously installed pneumatic caissons
Road tunnel constructed using continuously installed pneumatic caissons

Constructing a Long Tunnel by Continuously Sinking Multiple Caissons

Six two-level box-culvert caissons were positioned along a curved alignment and sunk in succession within a confined area close to critical infrastructure, including the Shinkansen and Saikyo Line. Despite the curved alignment and complex geological conditions, including soft ground and confined aquifers, sinking accuracy of within ±50 mm both horizontally and vertically was achieved. The work was carefully controlled to maintain groundwater levels and minimize the effects on nearby structures. A gap of approximately 2.5 meters remained between each caisson. These gaps were mechanically excavated and the caissons rigidly connected, creating a single, integrated 221.5-meter road tunnel.

Construction in progress
Construction in progress

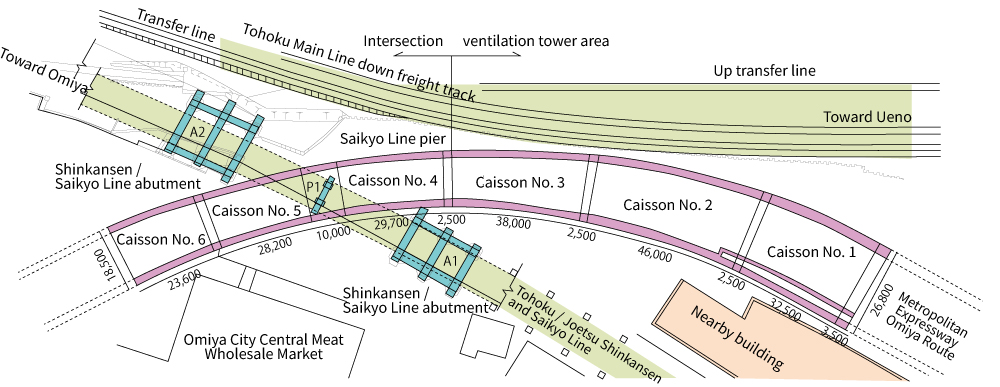

Plan view
Plan view

New Saitama East-West Expressway Connector Road between Kita-Yono and Omiya on the Saikyo LineLocation

Location
2-chome Kishikicho to 62 Nishikicho, Saitama City, Saitama Prefecture
Client
Tokyo Construction Office, East Japan Railway Company *Constructed under an agreement with the Metropolitan Expressway Public Corporation
Construction period
October 1999 – October 2003
Structure and scale
Plan dimensions: 23.6 m × 18.5 m to 46.0 m × 22.2 m Caisson area: 424–1,038 m2; six caissons
Depth: GL −31.5 m to −37.7 m

Construction of the World’s Largest Pneumatic Caisson by Plan Area
Higashiogu Water Reclamation Center Nishi-Nippori Pump Building

The Higashiogu Water Reclamation Center was planned as a sewage and stormwater treatment facility to improve water quality in the Sumida River and prevent eutrophication in Tokyo Bay. Shimizu constructed the Nishi-Nippori pump building.

Higashiogu Water Reclamation Center construction
Higashiogu Water Reclamation Center construction

The World’s Largest Pneumatic Caisson by Plan Area

The Nishi-Nippori pump building is a large underground structure with a plan area of 4,838 m2, equivalent to approximately 18 tennis courts, and a depth of 43.9 m below ground level. It was constructed using the world’s largest pneumatic caisson by plan area.

Recipient of the FY2011 JSCE Technical Award

Higashiogu Water Reclamation Center Nishi-Nippori Pump Building

Location
7-2 Higashiogu, Arakawa City, Tokyo
Client
First Core Facility Reconstruction Office, Bureau of Sewerage, Tokyo Metropolitan Government
Construction period
September 2006 – February 2011
Structure and scale
Plan dimensions: 62.1 m × 77.9 m Area: approximately 4,838 m2
Depth: GL −43.9 m

Construction of a Deep Shield-Tunnel Launch Shaft Using a Pneumatic Caisson
Tokyo Outer Ring Road Tomei JCT and Mainline Shield Tunnel Shaft

The pneumatic caisson method was used to construct the launch shaft that served as the base for mainline shield tunneling on the Tokyo Outer Ring Road between the Kan-Etsu and Tomei expressways.

Shield tunnel shaft construction
Shield tunnel shaft construction

Japan’s Third-Deepest Shield Shaft at the Time of Construction

The caisson was sunk to a depth of 70.3 m below ground level. At the time of construction, this was the third-deepest pneumatic caisson in Japan and, as of December 2025, it ranks fourth. It was also Shimizu’s deepest pneumatic caisson project at the time and involved the highest working pressure the Company had used, reaching a maximum of 0.462 MPa.

Three-Dimensional Design Eliminating the Frame Beam

A reinforcing beam is normally installed above the shield opening in a launch shaft. Before construction, however, the design was revised using three-dimensional FEM analysis, allowing this frame beam to be eliminated. Removing the beam increased the available interior space and improved the efficiency and constructability of the shield tunneling work.

*Frame beam: A beam installed in a shaft wall to reinforce the opening through which a shield machine is launched or received. It resists stresses from the machine’s thrust, earth pressure, and other loads, helping to ensure the stability of the shaft as a whole.

Example of three-dimensional FEM analysis results
Example of three-dimensional FEM analysis results
(Horizontal bending-moment diagram after formation of the shield opening)

Grid-Pattern SEW Method for a Large-Diameter Shield Opening

The SEW method*1 (developed by another company) was used at the opening so that the shield machine could cut through it smoothly during launch.
The opening had a large diameter of 16.2 m and was located approximately 60 m underground, resulting in substantial loads. FFU members*2, which are normally installed in only one direction, were therefore arranged in a grid and integrated with the concrete to increase structural strength. This was the first use in the industry of a composite structure that combines grid-arranged FFU members with concrete.

*1 SEW method: A method developed by The Zenitaka Corporation and Sekisui Chemical Co., Ltd. FFU members are incorporated into the section of an earth-retaining wall through which the shield machine will pass, enabling the machine to cut directly through the wall.

*2 FFU (Fiber Reinforced Foamed Urethane): A fiber-reinforced foamed urethane material formed into rectangular structural members by adhesive lamination.

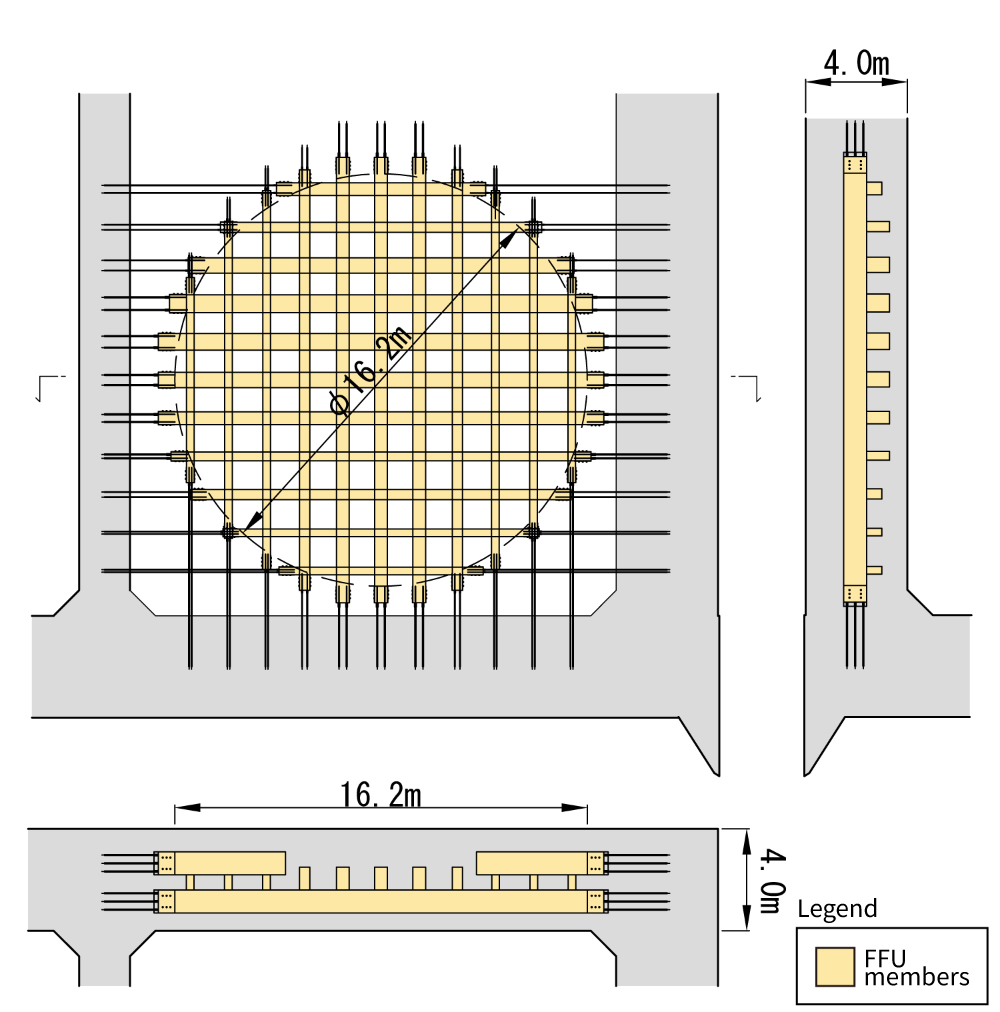

Composite structure combining grid-arranged FFU members and concrete
Composite structure combining grid-arranged FFU members and concrete

Tokyo Outer Ring Road Tomei JCT and Mainline Shield Tunnel Shaft

Location
Okura, Setagaya City, Tokyo
Client
Tokyo Branch, Central Nippon Expressway Company Limited
Construction period
September 2012 – September 2015
Structure and scale:
Plan dimensions: 48.2 m × 28.1 m Area: 1,354 m2
Depth: GL −70.3 m

Construction of an Underground Library Using the Pneumatic Caisson Method
University of Tokyo General Library Annex

To enhance the functions and expand the storage capacity of the General Library at the University of Tokyo’s Hongo Campus, Shimizu constructed an underground library equipped with an automated storage system capable of accommodating three million additional books. The existing General Library holds approximately 1.2 million books.
To preserve the campus landscape, the new facility was constructed beneath the fountain plaza in front of the existing library. Basement floors 2 through 4 contain the automated storage system, while basement floor 1 is used as a study area.

University of Tokyo General Library Annex: interior of the completed structure, basement floors 2–4
University of Tokyo General Library Annex: interior of the completed structure, basement floors 2–4

Confined Construction Area Surrounded by University Buildings

Construction was carried out under difficult conditions, with existing university buildings surrounding the site on all four sides. To minimize effects on the surrounding structures, steel sheet piles were installed to separate the caisson from the adjoining ground while also serving as earth-retaining walls. A friction-reducing material was also used around the caisson during sinking. Before work began, two-dimensional FEM analysis was performed to verify the effectiveness of these measures.

Construction within a confined area surrounded by university buildings
Construction within a confined area surrounded by university buildings

Water-Stop Steel Plates Covering the Entire Exterior Wall

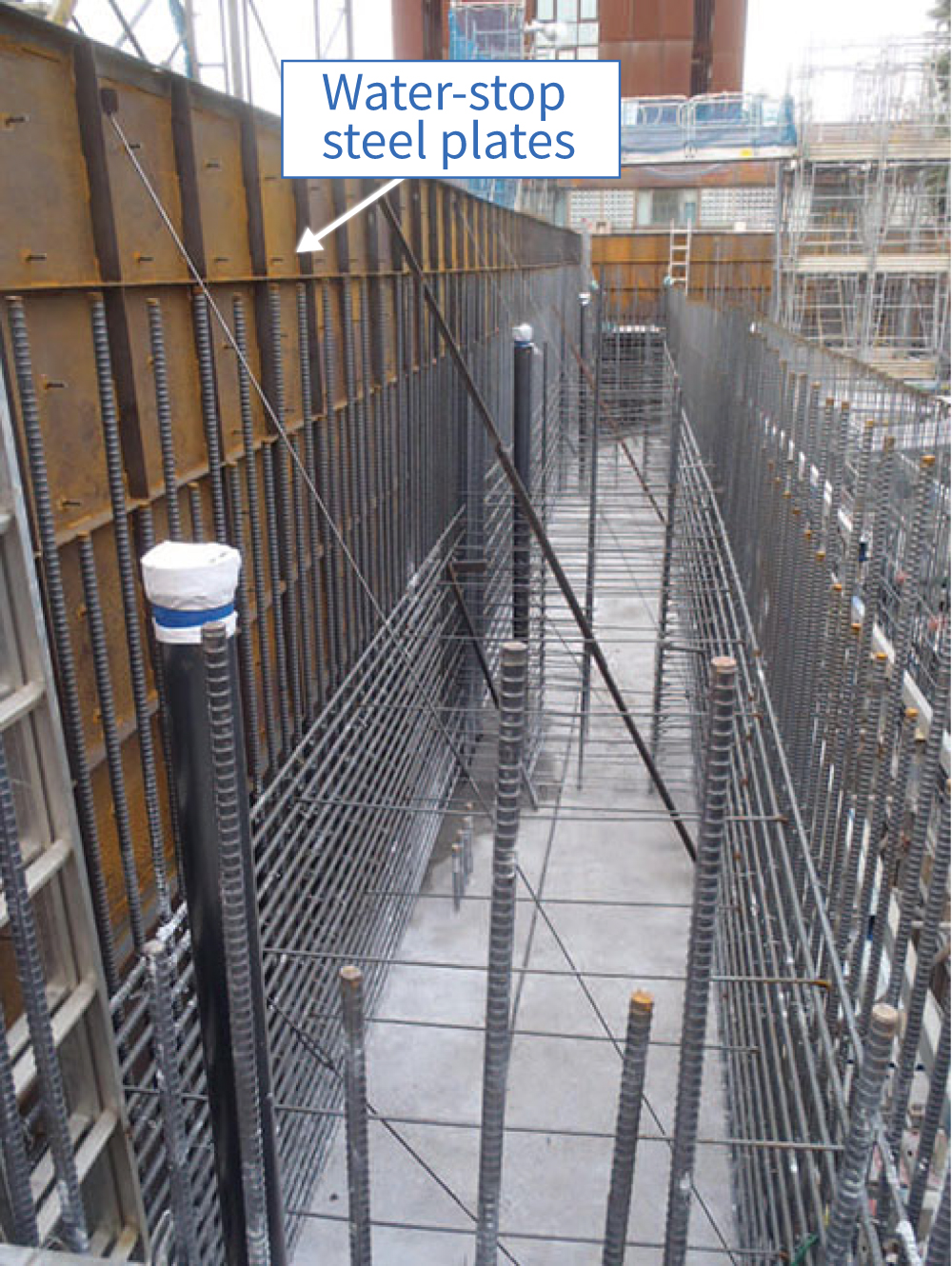

Temporary fixing of water-stop steel plates
Temporary fixing of water-stop steel plates

Because book storage areas must be protected from moisture, 6 mm-thick water-stop steel plates were installed over the outer surfaces of the exterior concrete walls and used as permanent formwork. The entire structure, including the cutting edge and bottom slab, was covered with steel plates to reliably prevent groundwater infiltration.

Promoting Sinking with Large Sandbags

The structure requires sufficient downward force from its own weight to sink. When the structure alone is not heavy enough, water is normally stored inside it to increase its weight. Because the completed structure would be used as a book storage facility, water was not used in this project. Instead, large sandbags and similar weights were placed inside to promote sinking.

大型土嚢による沈下促進の様子
Use of large sandbags to promote sinking

University of Tokyo General Library Annex

Location
Hongo, Bunkyo City, Tokyo
Client
The University of Tokyo, National University Corporation
Construction period
November 2014 – May 2017
Structure and scale
Plan dimensions: 44.2 m × 26.6 m Area: 1,176 m2
Depth: GL −46.3 m

Construction of One of Japan’s Largest and Deepest Pneumatic Caissons for a Pumping Station
Nagoya City Hirokawa Pumping Station

The Hirokawa Pumping Station is a stormwater drainage facility built to improve flood protection around Nagoya Station. It discharges rainwater from the upper Nakagawa Canal area and surrounding districts into the canal.

Hirokawa Pumping Station construction
Hirokawa Pumping Station construction

Japan’s Deepest Pneumatic Caisson Construction for a Pumping Station under High Air Pressure

The pumping station structure, measuring 52.0 m × 29.5 m in plan, approximately 1,530 m2 in area, and 63.7 m in depth below ground level, was constructed using the pneumatic caisson method. It is the deepest pumping station in Japan constructed by this method and is deep enough to accommodate the entire approximately 56-meter height of Nagoya Castle. Because pressure in the working chamber at the bottom of the caisson reached 0.62 MPa, equivalent to 6.2 atmospheres, excavation was performed remotely without workers inside the chamber.

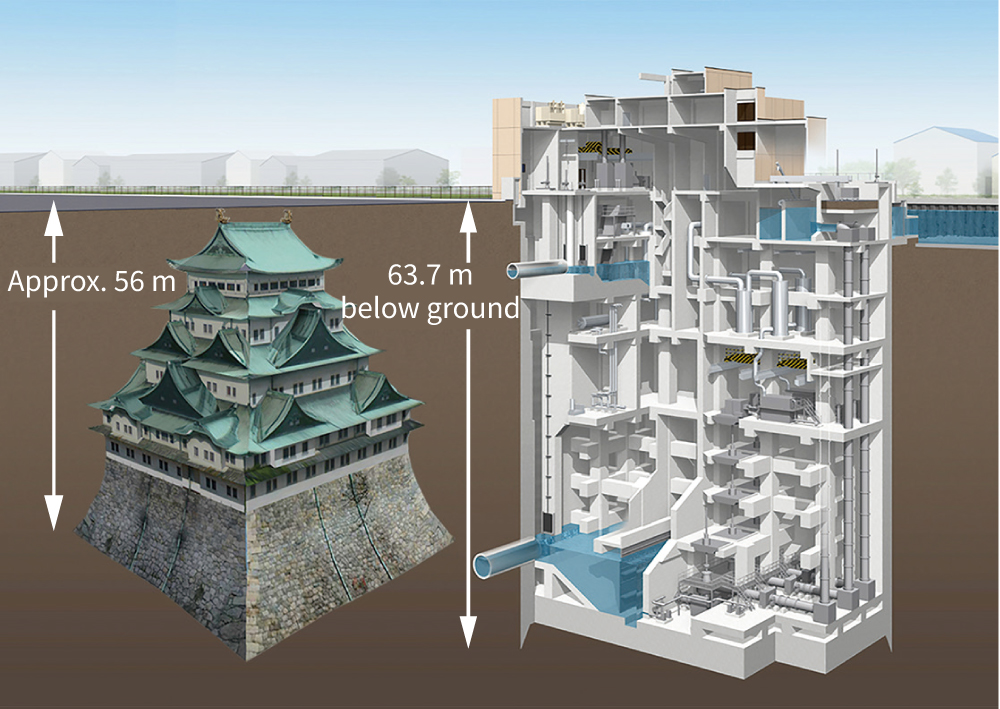

One of Japan’s deepest pumping stations: 63.7 m
One of Japan’s deepest pumping stations: 63.7 m

Shortening the Schedule by Postponing Internal Structure Construction

In a large pneumatic caisson project, sinking and excavation are normally carried out in parallel with construction of the exterior walls, slabs, and interior walls. For this project, the construction sequence was studied in detail using three-dimensional finite element analysis. The analysis verified, prior to construction, that reinforcing the exterior walls and beams would allow the exterior walls alone to withstand earth and water pressure, without requiring the interior walls or slabs to be reinforced. Based on this finding, the slabs and interior walls, which would otherwise have had a major effect on the overall schedule, were constructed after excavation was completed. This significantly shortened the construction period.

Nagoya City Hirokawa Pumping Station Construction No. 2

Location
Hirokawacho, Nakagawa Ward, Nagoya City
Client
Japan Sewage Works Agency (Project owner: Nagoya City Waterworks and Sewerage Bureau)
Construction period
November 2015 – May 2022
Structure and scale
Plan dimensions: 52.0 m × 29.5 m Area: approximately 1,530 m2
Depth: GL −63.7 m

Construction of a Convex Pneumatic Caisson with One of the World’s Longest Sides
Reconstruction of the Ishinomaki Chuo Drainage Pumping Station and One Other Facility

Stormwater drainage facilities and a main box culvert were constructed in central Ishinomaki, where ground subsidence caused by the Great East Japan Earthquake had created a need for additional flood-control measures.

Ishinomaki Chuo Drainage Pumping Station construction
Ishinomaki Chuo Drainage Pumping Station construction

Convex Plan Shape with Japan’s Longest Side, Measuring 89.7 m

The stormwater pumping station structure measures 89.7 m × 41.2 m in plan and has an overall depth of approximately 39 m, comprising a depth of 35.3 m below ground level plus the aboveground civil-engineering portion, and was constructed using the pneumatic caisson method. Because the structure had a convex plan shape, special care was required to prevent stress concentrations during sinking from damaging the corners along its long side. At 89.7 m, the long side is the longest in Japan for a structure constructed using the pneumatic caisson method.

Construction of the convex-shaped structure
Construction of the convex-shaped structure

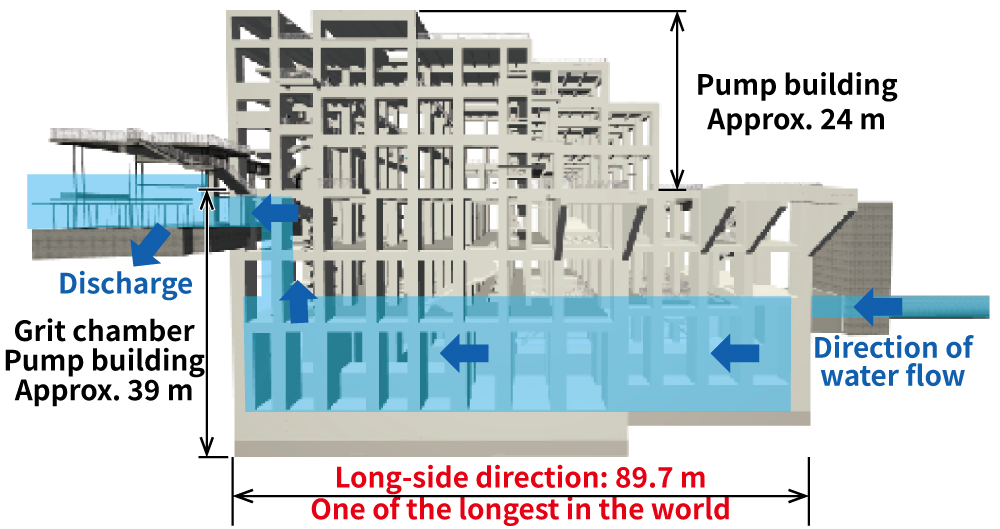

Cross section of the stormwater drainage pumping station
Cross section of the stormwater drainage pumping station

Pneumatic-Caisson Version of SP-MAPS

To ensure that a pneumatic caisson remains stable as it sinks, excavation is performed while portions of soil immediately inside the cutting edge are temporarily left in place.
For this project, Shimizu applied the pneumatic-caisson version of SP-MAPS, a system that visualizes excavation progress in these unexcavated areas around the cutting edge. The project confirmed the effectiveness of the system.

Excavation conditions visualized using SP-MAPS
Excavation conditions visualized using SP-MAPS

Recipient of the FY2023 JSCE Technical Award

Reconstruction of the Ishinomaki Chuo Drainage Pumping Station and One Other Facility, Parts 2 and 3

Location
Ishinomaki City, Miyagi Prefecture
Client
Japan Sewage Works Agency (Project owner: Ishinomaki City)
Construction period
February 2018 – March 2023
*External works continued through July 2023
Structure and scale
Plan dimensions: 89.7 m × 41.2 m Area: 3,362 m2
Depth: GL −35.3 m

Deeper, Larger, and More Precise. Shimizu’s Pneumatic Caissons

Shimizu has completed 29 pneumatic caisson projects since 2000.

Vietnam Tokyo Kanagawa Prefecture 20 21 22 23 24 25 26 27 28 29 4 5 6 7 8 9 10 11 12 13 14 15 17 18 19 1 2 3 16 Miyagi Prefecture Chiba Prefecture Kanagawa Prefecture Tokyo Vietnam Niigata Prefecture Toyama Prefecture Aichi Prefecture Nagano Prefecture Hyogo Prefecture Miyazaki Prefecture Nagasaki Prefecture Mie Prefecture Saitama Prefecture Ishinomaki Chuo Drainage Pumping Station, Ishinomaki City 1 Shin-Omiya–Ageo Road, Miyamae District bridge foundation 2 Saitama East-West Expressway Connector Road between Kita-Yono and Omiya on the Saikyo Line 3 Connecting pipeline between the Tokyo Shibaura Center andthe Morigasaki Water Reclamation Center 4 Oji No. 2 Pumping Station 5 Todoroki Bridge substructure 6 Tokyo Outer Ring Road, Tomei JCT and mainline shield tunnel shaft 7 Hachioji Nakano water-transmission pipeline shaft 8 University of Tokyo General Library Annex 9 Water-transmission pipeline shaft between 2215 Oyama-machi, Machida City, and Minami-Osawa 3-chome, Hachioji City 10 Komatsugawa No. 2 Pumping Station 11 Higashiogu Water Reclamation Center, Nishi-Nippori Pump Building 12 Nishi-Nippori trunk sewer shaft 13 Nippori–Toneri Liner Arakawa River crossing bridge substructure 14 Harutoyo No. 1 Bridge substructure 15 Edogawa No. 1 Final Treatment Plant, Main Pump Building 16 Kawasaki Port waterfront road, Higashi-Ogishima–Mizuecho Line, main bridge substructure 17 Daishigawara Pump Building 18 Gotanda River floodway outlet shaft 19 29 Bai Chay Bridge 20 Myoko Bridge replacement substructure 22 Inotani–Narahara Road, Katakake Bridge substructure 23 Nagoya City Hirokawa Pumping Station 21 Murayama Bridge substructure, Pier P3 26 Higashinada–Ashiya Line road improvement project, connecting bridge 28 National Route, Tenma Bridge substructure 27 Nagasaki Port, Megami District, bridge foundationand Megami Bridge substructure 24 Miyagawa Water Reclamation Center, screen and pump building 25 Owase deep-seawater intake facility

Safe and Reliable Construction of Social Infrastructure Using Pneumatic Caissons

The pneumatic caisson method makes it possible to safely and reliably construct underground structures without temporary earth-retaining walls, even in environments with high groundwater levels or in marine and river locations. The method contributes significantly to the construction of social infrastructure, including water and sewerage facilities and bridge foundations. Including the projects presented here, Shimizu has an extensive track record encompassing approximately 90 caissons. Applications have ranged from pier foundations and pumping stations to tunnel shafts and an underground library. The Company has also completed projects outside Japan, including in Vietnam and Bangladesh. Shimizu has continued to embrace new approaches, including the use of DX technologies such as SP-MAPS to improve structural construction accuracy, highly accurate prediction of surrounding-ground displacement using particle methods, and shorter construction periods achieved through innovative construction sequencing. We will continue striving to provide value that exceeds the expectations of society and our clients while contributing to the development of social infrastructure.
